When planning a control room, one of the most important questions to answer early is: How long does it take to manufacture control room furniture?
Summarized Takeaways
Control room furniture timelines vary based on customization, materials, and project size. Standard units can move faster, but most projects involve custom specifications, which typically require at least 16 weeks from order to delivery. Factors like custom HPL finishes, sit-stand features, and the number of workstations can extend timelines. Planning early and coordinating with Inracks helps ensure a smooth process from design through installation.

Warehouse showing Inracks Control Room Furniture being assembled for shipment.
The Answer Depends on Several Factors
Different variables impact the timeline, including the type of furniture, the number of operator positions, the degree of customization, material availability, finish selections, and whether installation is included in the project.
At Inracks, every control room is approached as a unique environment. Our furniture can be configured around the exact requirements of your facility, from workstation dimensions and accessories to monitor mounting and equipment integration. That flexibility allows you to maximize your available space, but highly customized furniture can require more planning and manufacturing time than standard configurations.
How Long Does Standard Control Room Furniture Take?
For projects using standard Inracks components, standard sizes, and readily available finishes, the manufacturing timeline can be considerably shorter than a highly customized project.
In-stock components and commonly specified colors may allow certain standard units to move into production more quickly. However, the final timeline still depends on the quantity of stations, selected configuration, material availability, factory scheduling, pre-assembly, and freight.
As a general planning guideline, standard or lightly customized furniture may be able to move from order to delivery in less than 16 weeks, depending on the specific project.
This is particularly relevant for customers who have straightforward requirements and are able to work within Inracks’ standard configurations and available materials.

FAQ Graphic showing frequently asked questions about control room furniture production timelines.
How Long Does Custom Control Room Furniture Take to Manufacture?
For truly custom control room furniture, Inracks recommends planning at least 16 weeks from order to delivery, with additional time required when installation is part of the project.
Inracks offers extensive customization options. Customers can specify their own dimensions, or our team can help develop specifications based on the room, equipment, workflow, and operator requirements.
Customization can include:
- Custom workstation widths and heights
- Custom configurations for individual operator positions
- Custom accessories
- Specialized equipment mounting
- Monitor mounting locations
- Cable management requirements
- Custom HPL colors and finishes
- Custom slat wall configurations
- Additional mounting points using the Inracks slat wall system
- Sit-stand workstation configurations
- Specialized equipment integration
The more customized the furniture becomes, the more planning and production steps may be required.
The number of controller stations can also affect the schedule. A small project with several standard stations may move through production differently than a large control room requiring dozens of highly customized positions.

Inracks warehouse executing quality control & assembly before shipment.
What Factors Can Affect the Control Room Furniture Manufacturing Timeline?
One of the biggest considerations is that control room furniture is not simply pulled from inventory and shipped. Even when Inracks stocks many standard components, individual projects may require materials to be ordered specifically for the customer’s configuration.
For example, HPL surfaces and certain sizing requirements may need to be ordered. Inracks maintains inventory of a number of standard components and colors, but if a project calls for a color outside the typical palette, the material may need to be ordered directly from the HPL manufacturer.
That means the timeline can be influenced by the manufacturer’s availability and lead time for the selected material.
The Type of Furniture Matters
The type of control room furniture being specified can also affect manufacturing time.
Edge units, for example, are a budget-friendly solution and can generally require fewer production steps than more advanced configurations.
Enterprise-level control room furniture typically involves additional features, customization, equipment integration, and finishing requirements, which can increase production time.
Sit-stand furniture can also require additional manufacturing steps. The sit-stand mechanism and related components require an additional tooling and production process, which can add time compared with a conventional fixed-height workstation.
For that reason, it is important to identify the desired furniture type early in the planning process.

Graphic showing production timeline for Inracks control room furniture.
What Does a Typical Control Room Furniture Timeline Look Like?
A good control room furniture schedule should account for much more than manufacturing alone. The overall project timeline typically includes order processing, engineering and specification review, material procurement, manufacturing, factory pre-assembly, freight, delivery, and installation.

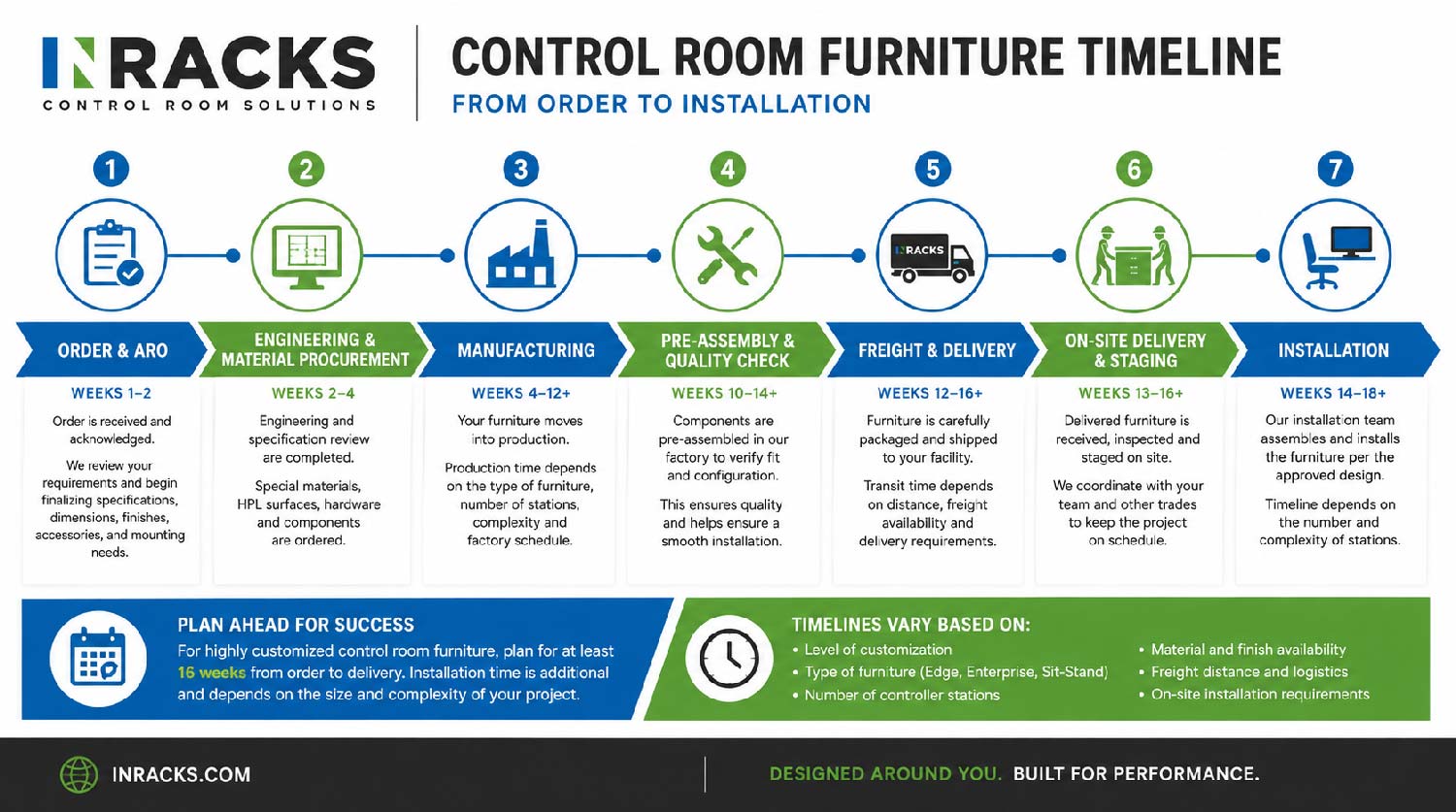

A typical custom project can be planned around the following schedule:
Weeks 1-2: Order and ARO
Once the order is received and the project is acknowledged, the Inracks sales and engineering team works with the customer to finalize specifications, dimensions, finishes, accessories, mounting requirements, and other project details.
Weeks 2-4: Engineering, Specification Review and Material Procurement
The project moves through the necessary design and specification review. Any non-standard HPL, hardware, components, or other materials that need to be ordered are identified and procured.
Weeks 4-12+: Manufacturing
Once specifications and materials are confirmed, the furniture moves into manufacturing. The exact production time depends on the furniture type, number of stations, complexity, and factory schedule.
Pre-Assembly: Factory Quality Check
Before the furniture leaves the factory, Inracks can pre-assemble components as appropriate to verify fit, configuration, and overall assembly requirements. Pre-assembly is an important part of the process because it helps identify potential issues before the furniture reaches the jobsite.
This step can also help the installation team understand exactly how the furniture is intended to go together, particularly on large or highly customized projects.
Weeks 12-16+: Freight and Delivery
Freight travel time must also be included in the project schedule. Once furniture leaves the factory, it still has to travel to the customer’s facility, and the distance, freight availability, delivery requirements, and jobsite scheduling can all affect the final delivery date.
For larger projects, freight may involve multiple trucks and staggered deliveries rather than one shipment.
Installation: Additional Time as Required
If professional installation is required, installation should be treated as a separate phase of the project. The Inracks installation team can coordinate with onsite contractors and other trades to help ensure the furniture is installed according to the approved configuration.
The installation timeline depends on the number of stations, complexity of the furniture, site access, existing conditions, and coordination with other work taking place in the facility.

Clients & supervisors giving feedback to Inracks console engineers.
Why Should You Plan Control Room Furniture Early?
The best way to avoid schedule surprises is to start the furniture planning process as early as possible.
For a truly custom control room furniture project, 16 weeks should be considered a minimum planning target, rather than waiting until the room is nearly ready for furniture.
Starting early gives the customer and Inracks team time to review the room layout, determine workstation dimensions, select finishes, identify equipment mounting requirements, order special materials, coordinate with contractors, and establish a realistic delivery and installation schedule.
It also gives the project team more flexibility if specifications change during the planning process.
In many cases, the customer ultimately chooses a highly customized workstation because the goal is to maximize the usable space within the control room. While that customization provides significant advantages, it also means the project will typically fall into the longer custom-furniture timeline.
How Can Inracks Help You Plan Your Control Room Furniture Timeline?
Your Inracks sales representative will work with you throughout the process to develop a realistic project timeline and keep you updated along the way.
We can help determine which components can be supplied from available inventory, identify items that may require additional lead time, coordinate custom specifications, and plan around your required delivery date.
If installation is required, we can also coordinate with onsite contractors and our installation team so the furniture schedule aligns with the broader construction and commissioning schedule.
The earlier we can become involved, the better we can help you develop a practical timeline.
Control Room Furniture Manufacturing Timeline: At a Glance
For planning purposes, consider these general guidelines:
- Standard or lightly customized units: Potentially less than 16 weeks, depending on configuration and component availability.
- Highly customized control room furniture: Plan for at least 16 weeks from order to delivery.
- Non-standard HPL colors or materials: Additional lead time may apply based on manufacturer availability.
- Sit-stand furniture: Additional production steps can increase the manufacturing timeline.
- Large multi-station projects: May require additional production, pre-assembly, freight, and installation coordination.
- Installation: Add time to the overall project schedule based on the number and complexity of stations.
These are planning guidelines rather than guaranteed lead times. Your Inracks sales representative can provide a project-specific schedule based on your exact requirements.
Frequently Asked Questions About Control Room Furniture Lead Times
How far in advance should I order control room furniture?
For a highly customized control room furniture project, Inracks recommends planning at least 16 weeks in advance. More complex projects may benefit from additional lead time.
Can Inracks provide standard control room furniture faster?
Potentially. Projects using standard configurations and in-stock components may have shorter lead times. The final timeline depends on sizing, quantity, finish, specifications, and current production capacity.
Does the number of control room stations affect the lead time?
Yes. Larger projects with more operator stations can require additional manufacturing, pre-assembly, freight, and installation coordination.
Do custom HPL colors increase the lead time?
They can. Inracks stocks a selection of standard colors and components, but non-standard HPL colors may need to be ordered from the HPL manufacturer. The availability and lead time of that material can affect the overall project schedule.
Does sit-stand control room furniture take longer to manufacture?
Sit-stand configurations can require additional tooling and production steps compared with fixed-height furniture, so they may add time to the manufacturing schedule.
Does the 16-week timeline include installation?
The 16-week guideline is primarily intended as a planning target for custom furniture through manufacturing and delivery. Installation should be planned as an additional project phase based on the size and complexity of the installation.
Can Inracks help with control room furniture installation?
Yes. Inracks can work with onsite contractors and can provide installation services when required. Installation should be discussed early so it can be incorporated into the overall project schedule.
Start Planning Your Custom Control Room
A successful control room project starts long before the furniture arrives at the jobsite. By involving Inracks early, you can establish realistic expectations for design, material procurement, manufacturing, delivery, and installation.
Ready to build your dream control room? Contact the Inracks team to discuss your requirements, develop your custom workstation specifications, and create a realistic timeline from order to installation.
